Fushi II Hydro Power Plants Officially Join the Grid and Start Generation
Publish:2015-07-27

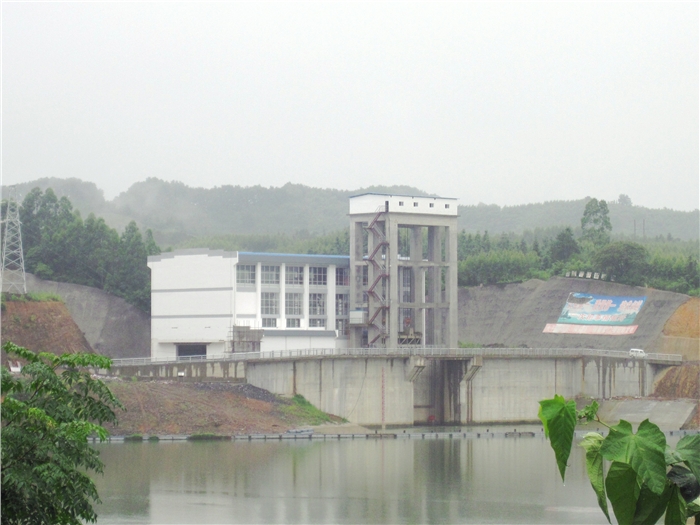

On 26 Jul, 15:12 P.M., Fushi II Hydro Power Plants joined the grid and start generation. All power will be delivered to system for dispatching. Based on current water flow, the units were operating with 15MW of loading.

Since Fushi II generation units joined the grid and commissioned for water filling test on Jun 30, more than 16 tests like first launch, automatic on/off, generator up-lifting and etc. and all data met the requirement of entering 72-hour grid-connection test. On Jul 7, 11:01, Rong’an hydro power units official connected the grid and started 72-hour test run.
